IB Business Management HL 2.1 Introduction to human resource management Questions

Evaluate how human resource strategy, workforce planning and employee relations influence organizational performance in IB Business Management HL.

28 questions in this syllabus scope, with question parts counted together.

Syllabus
First assessment 2024
Course
Business management HL
Level
HL

Exam points

  • Analyse HRM through planning, recruitment, training, appraisal, communication and employee relations.
  • Evaluate HR planning responses to demographics, labour mobility, immigration, flexi-time and gig work.
  • Evaluate change-resistance strategies using communication, participation, support, negotiation and leadership.

2.1.1—Role of human resource management SL/HL

4 more questions
  • Analyse human resource implications of management decisions and workforce changes in business cases.

Question 1

Paper 2SL/HL
[Maximum number: 4]

Creative Toys (CT) manufactures toys and markets them business-to-customers (B2C) online only.

Creative Toys (CT) manufactures toys

The management has prepared forecasted financial data for CT, for 2015, based upon the proposed change to the marketing mix, shown in Table 2 below.

Creative Toys (CT) manufactures toys and markets them business-to-customers (B2C) online only. The business operates in a leased industrial site and relies on word-of-mouth promotion only. To make customers believe that CT’s toys are better than its competitors, CT sets prices slightly higher than the competition. Production and sales are mostly between 1 October and 24 December. Most of the employees work on temporary contracts during this busy period. For the remainder of the year, CT operates well below capacity utilization.

In 2014, the management of CT considered a change of the marketing mix to include above the line promotion, lower prices, and an additional sales method called “toy parties”. Toy parties would be hosted by newly recruited CT sales representatives and attended by parents and their children. At the parties parents could see the toys and children could play with them. Sales would be made at the parties by the new sales representatives, who would be paid on a commission-only basis. Toy parties could be held throughout the year and make CT’s total sales less seasonal.

Creative Toys (CT)


Creative Toys (CT) manufactures toys and markets them business-to-customers (B2C) online only. The business operates in a leased industrial site and relies on word-of-mouth promotion only. To make customers believe that CT's toys are better than its competitors, CT sets prices slightly higher than the competition. Production and sales are mostly between 1 October and 24 December. Most of the employees work on temporary contracts during this busy period. For the remainder of the year, CT operates well below capacity utilization.
Table 1 contains selected data for CT, for 2014:

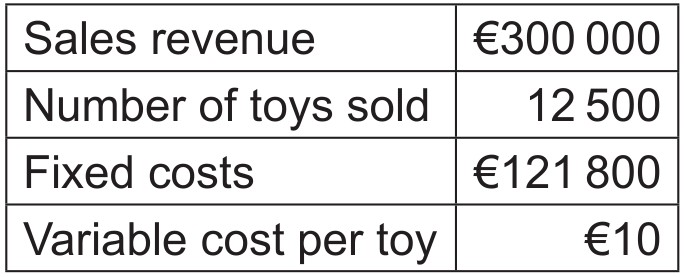

Table 1

Table 1

In 2014, the management of CT considered a change of the marketing mix to include above the line promotion, lower prices, and an additional sales method called "toy parties". Toy parties would be hosted by newly recruited CT sales representatives and attended by parents and their children. At the parties parents could see the toys and children could play with them. Sales would be made at the parties by the new sales representatives, who would be paid on a commission-only basis.

Toy parties could be held throughout the year and make CT's total sales less seasonal. Based on market research, management has estimated that the parents' demand for toys is price elastic and is planning to set lower prices for all toys sold online and at toy parties. The management has prepared forecasted financial data for CT, for 2015, based upon the proposed change to the marketing mix, shown in Table 2 below.

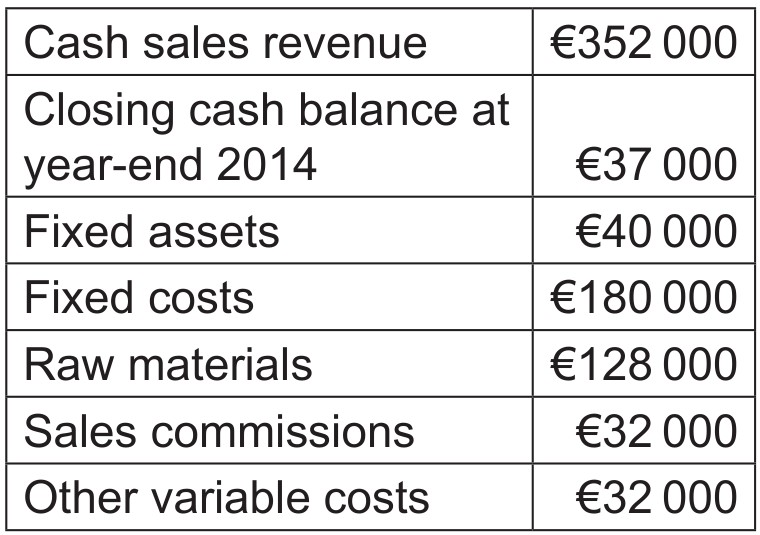

Table 2

Table 2

The Finance Manager will carry out a variance analysis in order to determine whether the proposed change to the marketing mix has been successful.

Explain two possible human resource implications for CT's management given the proposed change to introduce "toy parties" as an additional sales method.

2.1.2—Human resource planning factors SL/HL

16 more questions
  • Analyse how demographic change, globalization, culture, labour mobility and flexible working affect human resource planning and strategy.

Question 1

Paper 1SL/HL
[Maximum number: 2]

Just before the Board of Directors voted on “RDB 2020”, Anna Holstein had a serious car accident. She would require years of physical therapy before working again. Board members now have two important decisions to make:  Whether to approve the “RDB 2020” strategic plan. Despite Valdemar Holstein’s opposition, some board members still supported it, especially because of a recent workforce planning study (Item 1). To help them decide, the board requested and received a decision tree and critical path analysis (Items 2 and 3).  Who would replace the 83-year-old Valdemar? The succession plan had always been to promote his daughter Anna to Chief Executive Officer (CEO).

Royal Danish Bearings (RDB) is a successful multinational company operating in the ball bearing industry. RDB was set up in 1915, in Denmark, by a Danish machinist called Henrik Holstein. Henrik was a visionary. He foresaw the expansion of the ball bearing industry in the twentieth century, which was largely due to the growth of the automotive sector. Ball bearing technology contributed to engineering progress throughout the twentieth century, especially in the secondary sector of the economy. Today, the outlook of the ball bearing industry is still promising: its market size is predicted to further expand over the next decades. “High-tech industries” such as computer software and artificial intelligence attract considerable attention and capital; however, most global industrial output continues to be mechanical devices. For example, ball bearings are found in all types of vehicles, such as in gearboxes and wheel suspension; there are even ball bearings in fighter jets and space shuttles. RDB has always operated in the business-to-business (B2B) market. Throughout the twentieth century, it expanded by internal/organic growth. Consistent with business thinking of that era, the company concentrated its manufacturing in three megafactories (very large factories) located in Denmark, northern Germany and Sweden, where the workforce had become highly skilled in operating machinery for industrial production. Benefiting from several economies of scale, RDB created thousands of jobs, supporting the “company towns” where they were the main employer, held in high esteem both locally and regionally.

RDB remained profitable and maintained brand loyalty. However, financially, gross and net profit margins were lower than previously, which Valdemar thought was unavoidable. Internally, some maintenance and technological upgrades were being delayed – but Valdemar did not pay attention to this. Externally, some environmental campaigners started to put pressure on RDB because of the high pollution levels in the vicinity of RDB factories – but Valdemar ignored their claims. Valdemar was proud of the company’s traditions. It remained privately owned by members of the Holstein family. Valdemar, like his father, had a paternalistic leadership style – though he could occasionally be autocratic, especially when the workers’ collective bargaining agreements were being renegotiated. Although there were few opportunities for promotion, the employees liked RDB’s corporate culture. They too were proud of working for a well-known, well-established and well-respected company. They were well paid, enjoyed working in a culturally homogeneous environment, and felt that their jobs were secure. Many of the workers’ fathers and, in some cases, their grandfathers, had worked for RDB. Work patterns and practices followed the northern European Christian calendar and local traditions. Getting a job at RDB was like “joining a family”. The employees all appreciated their job security, their high standard of living and their working environment. A cautious manager, Valdemar always tried to manage risks. He regularly consulted economists and other specialists in order to minimize the impacts of changes in the external environment. Over the years, these efforts proved worthwhile. For example, RDB remained largely unaffected by the 1970s energy crisis. Every year, Valdemar reviewed RDB’s contingency plans; this helped him avoid a possible technological disaster in 2000 with the so-called “millennium bug”. A crisis that Valdemar had not foreseen was the sudden collapse of Icelandic banks Kaupthing and Landsbanki in 2008; RDB had funds in saving accounts in those two banks. However, it later managed to recover most of these funds. In terms of operations, RDB manufactured standard-sized ball bearings in a flow production process. It sometimes used batch production for deliveries to established customers who used non-standard-sized ball bearings, and sometimes job production for one-off special orders, such as large ball bearing systems for power stations or mines. In all respects, from human resource management to operations, Valdemar felt that RDB was ready for the twenty-first century.

Anna had big ideas for RDB. A scientific and analytical thinker, she had carefully studied the external environment in which RDB operates. She knew that demand for ball bearings was slowing down in Europe, whereas it was growing substantially in countries such as Brazil, China and India that were going through a phase of strong industrialization. From her research, she also concluded that manufacturing in the twenty-first century would be accomplished in smaller, more flexible factories, instead of the huge modernist structures typical of the late nineteenth and twentieth centuries. Time would be the critical factor; having factories close to customers’ locations would reduce response time and improve logistics, including distribution and delivery. This would also shorten the working capital cycle – an important benefit for RDB. Given her international experience, working at RDB made Anna realize that her colleagues in the Engineering Department, and even the entire RDB workforce, needed a better cultural understanding of their customers. The best way to achieve this, she thought, would be through a workforce that resembled RDB’s customers, and increasingly they would be from Asia, India and South America. She was also convinced that RDB had to focus on “green” technologies and its corporate social responsibility. The company would have to significantly increase its spending on research and development (R&D) and also examine its impact on the environment and on its customers’ carbon footprint. The two are linked, Anna reasoned: the ultimate aim of innovation in the ball bearing industry is to save energy, which is fundamentally what ball bearings do by reducing friction. For users, better ball bearings mean less friction and, in turn, less friction means that less energy is wasted. Thus, less energy is needed. Anna’s vision for RDB was to make the world’s most technologically advanced, energy-efficient ball bearings in small “green” factories located near its customers. This would require selling the two megafactories in northern Germany and Sweden, and significantly downsizing the one in Denmark. RDB’s production would be offshored to 12 small factories to be opened around the world, mainly in Brazil, China and India. In terms of workforce planning, each of those new RDB factories would be jointly managed by one experienced RDB senior manager from Europe and one local manager familiar with the language and culture. Some machinists from RDB’s European factories would be offered key positions. Most of the existing jobs in Europe would be made redundant, as most of the new workers would be recruited locally on lower wages. Northern European countries have generous redundancy payments, largely funded by the employers, and these costs would be significant in the short term. In the long term, however, RDB would lower labour costs. Marketing would also play a major role in the new RDB that Anna imagined. RDB’s marketing department had always been “sleepy”, with a small budget and unchallenging objectives. Advertising and promotion were limited to some trade journals and trade shows. Anna thought that this should change. She believed that RDB should advertise in a wider range of publications, including e-zines (online magazines) and professional web sites for industrial design and architectural robotics. She wanted to use information and communication technology (ICT) to communicate to a wider range of external stakeholders. That way, RDB would create brand awareness in the design community, and not just in the manufacturing community. The marketing department should start carrying out market research, both primary and secondary. Anna also pictured groups of RDB “engineers-turned-salesmen” calling on major manufacturers to generate orders, whilst other staff would pressure politicians for more legislation and incentives to support environmentally-friendly products.

Anna wrote all the details of her ideas in a strategic plan that she named “RDB 2020”. She calculated that the transition costs for such a large-scale restructuring would be enormous. In order to generate 50 % of the funds required, RDB would need to sell the two megafactories in northern Germany and Sweden. For the rest of the funds, Anna would list RDB on the Frankfurt Stock Exchange: RDB would become a public limited company, with funds generated from the sale of newly issued shares. Anna was very pleased with her overall strategy for RDB; she found it coherent, consistent and forward-looking. Valdemar’s counterproposals Valdemar was stunned when Anna explained her “RDB 2020” strategic plan to him. Although he recognized that manufacturing was shifting away from Europe, and that RDB had to become more environmentally conscious, he had major objections. “RDB is a Danish company”, he insisted, “we managed to expand significantly after the first world war thanks to a major contract from the Danish government”. He felt a moral obligation to provide jobs in Denmark. At times, RDB had also formed public-private partnerships with the Swedish and German governments for various projects. The workforce was local and loyal; Valdemar felt like a father to them; a major retrenchment would be a violation of the “social contract” he implicitly had with them. He also despised the idea of RDB going public. Despite Anna’s assurances that the Holstein family would still be the major shareholder, he did not want to answer to shareholders who were not family members and had no sense of the company’s history or traditions. He had a bad feeling about this. He also did not like the idea of the relocation of the factories. A lifelong industrialist, he loved to see his three megafactories in northern Europe. Their scale of operation was so vast that expansions had been coordinated with the local urban planning authorities; the Swedish factory was so large that railroad lines had been installed in order to deliver supplies and to transport finished products. It was beyond his imagination that small factories operating in industrial parks on the outskirts of Mumbai or São Paulo could accomplish the same as the European ones. Despite Valdemar’s objections, Anna told him that she would speak to other shareholders in the family and could collectively force the company to change. He asked her for time to come up with an alternative proposal that would incorporate “some” of her ideas. A month later he suggested the following to her: • Rebrand the company, changing its name from “Royal Danish Bearings” to “Green Bearings, an RDB Company” and adopt Anna’s marketing strategy. Green Bearings would be “green” in name only. • Remain in northern Europe, but divide each of the three megafactories into autonomous cells, each assigned to serve a region of the world and each with its own strategic and tactical/ operational objectives. Local salesmen would be hired, paid low salaries, but with high commissions as an incentive. This would make the company look more international, but the current workforce in Europe would not change. • Form strategic alliances with ball bearing companies in Brazil, China and India.

Anna’s vision for RDB was to make the world’s most technologically advanced, energy-efficient ball bearings in small “green” factories located near its customers. This would require selling the two megafactories in northern Germany and Sweden, and significantly downsizing the one in Denmark. RDB’s production would be offshored to 12 small factories to be opened around the world, mainly in Brazil, China and India. In terms of workforce planning, each of those new RDB factories would be jointly managed by one experienced RDB senior manager from Europe and one local manager familiar with the language and culture. Some machinists from RDB’s European factories would be offered key positions. Most of the existing jobs in Europe would be made redundant, as most of the new workers would be recruited locally on lower wages. Northern European countries have generous redundancy payments, largely funded by the employers, and these costs would be significant in the short term. In the long term, however, RDB would lower labour costs.

Just before the Board of Directors voted on "RDB 2020", Anna Holstein had a serious car accident.

She would require years of physical therapy before working again.

Board members now have two important decisions to make:
- Whether to approve the "RDB 2020" strategic plan. Despite Valdemar Holstein's opposition, some board members still supported it, especially because of a recent workforce planning study (Item 1). To help them decide, the board requested and received a decision tree and critical path analysis (Items 2 and 3).
- Who would replace the 83-year-old Valdemar? The succession plan had always been to promote his daughter Anna to Chief Executive Officer (CEO).

There are two candidates for Valdemar's post:
- Jens Holstein, 68, is Valdemar's younger brother. He currently manages the large law firm responsible for most of RDB's legal affairs. He understands all the legal issues related to "RDB 2020". He always pays close attention to detail. In the law firm, he is well respected for his efficient management style, although some lawyers feel that he monitors their work too closely.
- Per Pederson, 44, is the manager of RDB's Swedish megafactory. Though originally hired because of his engineering degree, he was rapidly promoted thanks to his excellent "people skills". Quickly bored with budgeting and industrial planning meetings, Per preferred building relationships with employees and mentoring junior managers. He loved talking to workers and giving speeches about RDB. Valdemar was proud of having "discovered" Per, though some employees criticise his lack of attention to detail.

Regarding the management succession, Valdemar said that "choosing between Jens and Per is the same as choosing between a manager and a leader: it is a key strategic decision for RDB".

Item 1: Extract from workforce planning study

Northern Europe: Population by age groups, 1950–2050

000s% of total population
1950197019952025205019501970199520252050
Age 0–14184982110218199159671461623.724.219.416.716.1
Age 15–64515525528960997594505328866.063.365.162.058.8
Age 65+80451095714485204592275610.312.515.521.325.1
Total7809587348936819587690660100.0100.0100.0100.0100.0

Source: http://webarchive.iiasa.ac.at

Item 2: Decision tree regarding “RDB 2020” (all figures in € millions)

OptionOutcomeProbabilityYear 1Year 2Year 3Year 4Year 5Total
Option A: RDB 2020Success0.44151556062269
Option A: RDB 2020Satisfactory0.24041425160234
Option A: RDB 2020Failure0.43530252025135
Option B: No major changeSuccess0.13940414243205
Option B: No major changeSatisfactory0.83839404142200
Option B: No major changeFailure0.13738394041195

The figures are net profit after interest and tax.

Item 3: Critical path analysis for restructuring resulting from “RDB 2020”

ActivityActivityOrder/DependencyEstimated duration (months)
AConstruct and open two factories in BrazilCan start at the same time as B6
BSell megafactory in SwedenCan start at the same time as A15
CConstruct and open two factories in IndiaMust follow A6
DConstruct and open two factories in ChinaMust follow B and C6
ESell megafactory in northern GermanyMust follow B and C15
FConstruct and open two factories, one in Australia and one in KenyaMust follow D6
GConstruct and open one factory in ChileMust follow E and F3
HDownsize megafactory in DenmarkMust follow E and F6
IConstruct and open three more factories in ChinaMust follow G and H6

Total estimated duration: 42 months.

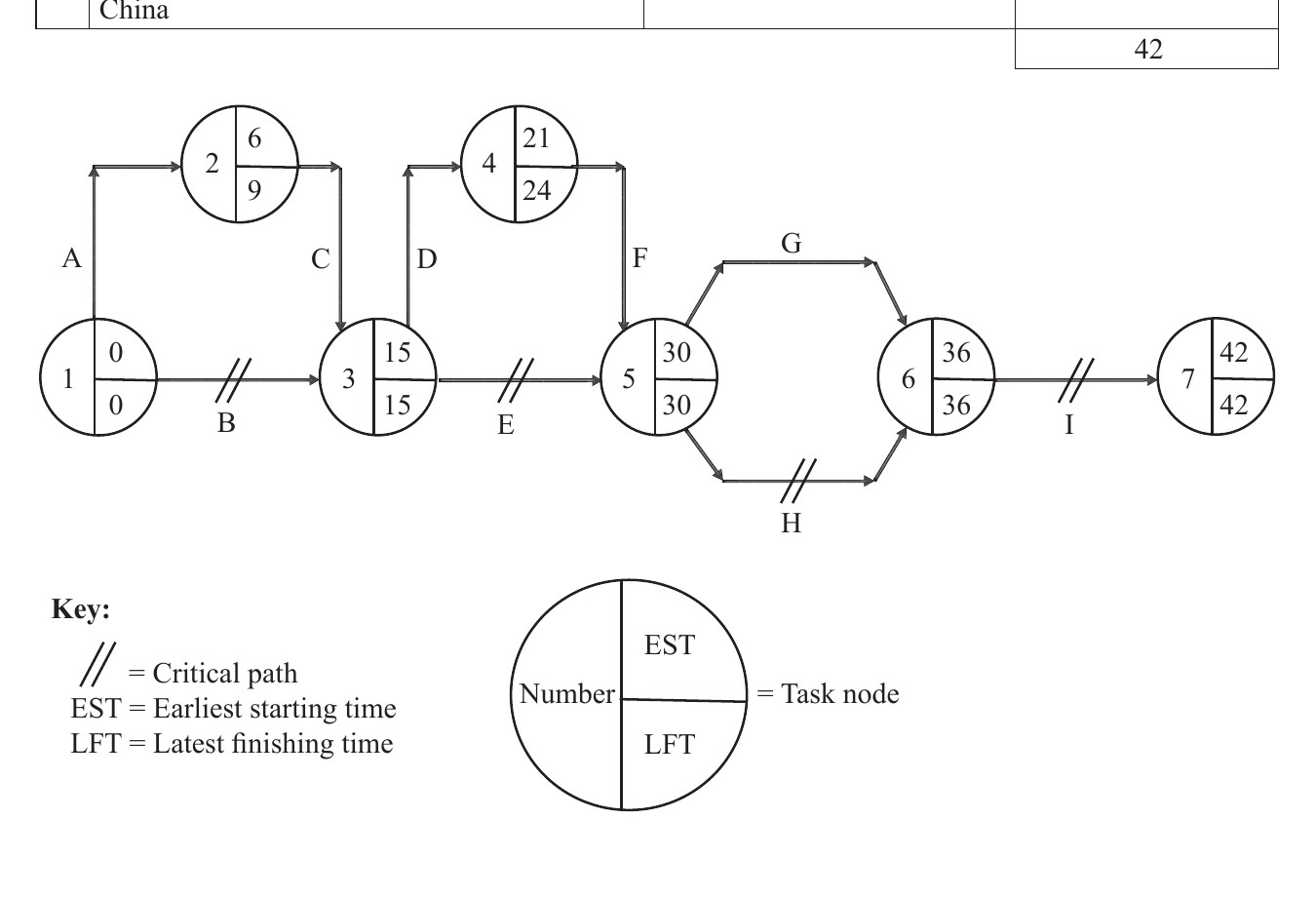

Item 3: Critical path network diagram and task-node timings

Item 3: Critical path network diagram and task-node timings

Item 4: Extract from The risky century: Crisis management in the twenty-first century (2012), by Toujours Paura

The twenty-first century will be the riskiest era for businesses since the fall of the Roman Empire. Technological change, environmental catastrophe, uncertain energy sources, employee theft and terrorism are just some of the many risks that businesses will face. Chief Executive Officers (CEOs) can no longer imagine that their job is merely to manage their organization, to lead change, and to manage traditional business risks. The twenty-first century CEO must also be creative in anticipating potential threats, both direct (traditional business threats) and indirect (crises of any variety). They must have detailed crisis management plans for every crisis imaginable, however unlikely …

Item 5: Extract from The creative century: How creative firms will win in the twenty-first century (2013), by Robert McFerrin

In the twenty-first century, business, especially Western business long accustomed to critical business advantages, will have to be creative. Because of their high cost structure, Western businesses must seek to add value through creativity. Many forces can prevent creativity and above all create a climate of fear and kill creativity. When Chief Executive Officers (CEOs) plan for every crisis possible, they foster a climate of fear. They communicate the message that any threat of loss matters more than the rewards of innovation and adaptability. The responsible CEO of the twenty-first century will reasonably plan for contingencies, but never to the degree that it cultivates fear … Any catastrophe must be viewed as an opportunity.

Item 1: Extract from workforce planning study

Northern Europe: Population by age groups, 1950–2050

000s% of total population
1950197019952025205019501970199520252050
Age 0–14184982110218199159671461623.724.219.416.716.1
Age 15–64515525528960997594505328866.063.365.162.058.8
Age 65+80451095714485204592275610.312.515.521.325.1
Total7809587348936819587690660100.0100.0100.0100.0100.0

Source: http://webarchive.iiasa.ac.at

Referring to Item 1, identify for RDB one opportunity and one threat as a result of demographic changes forecasted in the twenty-first century.

2.1.3—Resistance to change SL/HL

3 more questions
  • Analyse causes of employee resistance and evaluate change-management decisions in reorganisation, market entry and new strategies.

Question 1

Paper 1SL/HL
[Maximum number: 4]

In 2010, ELE’s directors decided to set up a car rental business financed by a combination of retained profits and external finance. Giselle was appointed director of the car rental division.

Giselle was passionate about change and the need to modernize. On her office door hung a sign: “Embrace change with open arms”. This slogan became Giselle’s mantra. She wanted to grow the car rental division further. In 2015, she gained board approval to open car rental offices in all the major airports in Belgium, France, Spain and the UK, and implemented a car rental booking service at ELE gasoline stations. Now, ELE car rentals can be booked online, over the telephone, and face to face at one of their counters in gasoline stations or at any airport office. ELE is also considering launching a smartphone booking app that would allow customers to book a rental car in less than a minute.

Giselle wanted Monica to become the director of a new car rental division in India. However, Monica disagreed completely with her mother. During a gap year in the USA, she saw how, in one city, a new innovative business model using disruptive technology had changed the car rental market. She compared this new business model to the impact that companies like Uber had on the taxi industry. Rather than enter the Indian market, Monica recommended a fundamental change to the ELE car rental division in Europe: to gain first-mover advantage, she wanted to launch a new brand, In3T, enhanced by technology. For this new brand:
• all cars would be electrically powered;
• customers would sign up as members;
• membership would be free;
• members would book a car using the In3T smartphone app;
• car availability would be identified using the In3T app;
• cars would be hired by the hour and unlocked and started using the app;
• cars could be left, at the end of the rental period, at any of the many designated locations in the city. This service would have few overheads. Booking offices would not be needed. A call centre that is available 24 hours a day would handle any member queries.

In 2021, Monica recommended that ELE trial the business model she had proposed for the new In3T brand in two major cities in the EU for one year: if successful, the brand and its model could then be launched in all major cities in the EU. Monica said, “We must do it. I’m convinced that our rivals will adopt this business model within two years. If we don’t act now, we will be left behind and our rivals will beat us to it.” Giselle, however, disagreed strongly. She had built the car rental division from its inception. She believed high levels of customer service and well-trained staff were two reasons why the car rental division remained successful. She was also unhappy with the EUR 100 million cost and payback of three years.

In 2016, Giselle also reorganized ELE’s car rental offices so that each office operated as a profit centre. An entrepreneurial approach was adopted. Office teams received substantial bonuses if they exceeded profit targets, but only offices that met their targets qualified for these bonuses. These targets were set, without consultation, by Giselle. Over a five-year period, targets were met by 85 % of offices. Giselle’s reorganization was not welcomed by employees.

Initially, the MiniC compressor was sold only in ELE’s gasoline station stores, but Lucas realized another distribution channel was needed. Within a year, the MiniC was on sale in thousands of retail outlets across the EU. Gasoline station retail stores were later refurbished, floor space increased, and point-of-sale stock management software installed. In 2010, ELE set up a car rental business financed by retained profits and external finance. Giselle wanted to grow the division. Car rentals could be booked online, over the telephone and face to face at counters in gasoline stations or airports. ELE was considering launching a smartphone booking app. The car rental division adopted graduate recruitment and annual training. Giselle encouraged internal recruitment and wanted employees with ambition and initiative, employees who shared her belief in embracing change, and internal promotion when management vacancies arose. The gasoline station compressor market is saturated but consistently profitable. The Zeat factory will not require additional investment for another five years. Sales of the MiniC were consistent despite increased competition from cheap imports. Gasoline station revenues face the challenge of declining gasoline sales as governments and car companies move away from gasoline and diesel cars. Giselle’s presentation highlighted that most car rental businesses in India are small and local, own 20–50 cars and operate in only one or two cities. Only 4 % of cars on roads were rental cars, foreign and domestic tourism was growing, urbanization was rapid and public transportation was basic but cheap. Monica recommended a fundamental change to the European car rental division: to gain first-mover advantage, she wanted to launch a new technology-enhanced brand, In3T. All cars would be electrically powered, customers would sign up as members, membership would be free, and members would book and locate cars using a smartphone app. Cars would be hired by the hour and could be left at designated city locations. The service would have few overheads and no booking offices.

In 2010, ELE owned 4.5 % of the European Union (EU) car rental market. In 2019, ELE's car rental division had revenues of EUR 0.9 billion in a market worth EUR 16.8 billion. Initially, ELE only provided car rentals in its gasoline stations in Belgium. By 2014, ELE had expanded the service to its stations in France, Spain and the UK.

In 2016, Giselle also reorganized ELE's car rental offices so that each office operated as a profit centre. An entrepreneurial approach was adopted. Office teams received substantial bonuses if they exceeded profit targets, but only offices that met their targets qualified for these bonuses. These targets were set, without consultation, by Giselle. Over a five-year period, targets were met by 85 % of offices. Giselle's reorganization was not welcomed by employees.

In 2021, Monica recommended that ELE trial the business model she had proposed for the new In3T brand in two major cities in the EU for one year: if successful, the brand and its model could then be launched in all major cities in the EU. Monica said, "We must do it. I'm convinced that our rivals will adopt this business model within two years. If we don't act now, we will be left behind and our rivals will beat us to it."

Giselle, however, disagreed strongly. She had built the car rental division from its inception. She believed high levels of customer service and well-trained staff were two reasons why the car rental division remained successful. She was also unhappy with the EUR 100 million cost and payback of three years.

Explain two reasons why ELE's employees may have resisted the reorganization implemented by Giselle.

2.1.4—Reducing change resistance SL/HL

3 more questions
  • Analyse causes of employee resistance and evaluate change-management decisions in reorganisation, market entry and new strategies.
